SAP implementations involve multiple testing phases before go-live, and two of the most important are System Integration Testing and User Acceptance Testing. While both validate that the system works correctly, they serve different purposes, involve different people, and happen at different points in the project. Understanding where each fits helps teams avoid costly mistakes and keeps the entire testing lifecycle on track. Tools like aqua cloud help SAP project teams manage both phases from a single platform, reducing the coordination overhead that typically slows large implementations down.
What Is SIT (System Integration Testing) in SAP?

SAP UAT and SIT are often confused because they share the same goal of validating system behavior, but SIT in SAP specifically focuses on the technical layer. System Integration Testing in SAP validates that different modules, systems, and third-party integrations work together as expected, and it happens after unit testing is complete and before the project moves into user-facing validation.
The focus of SIT in SAP is on data flow and system behavior across connected components. A QA engineer running a typical SIT scenario might create a purchase order in MM and confirm that the corresponding accounting entry appears correctly in FI. Key areas covered during this phase include:
- Data flow between SAP modules like FI, MM, SD, and HR
- Connections to external systems such as payroll tools or warehouse management platforms
- Configuration accuracy across integrated processes
- Error handling when data passes between systems
System Integration Testing in SAP is run by QA engineers and technical consultants who understand the system architecture. Business users are generally not involved at this stage. Test cases are written against functional specifications, and any failure points to configuration gaps, missing mappings, or integration defects that need resolution before the system moves to business validation.
This phase requires a stable environment with realistic data. Running SIT in SAP against incomplete configuration or placeholder data produces misleading results and forces teams into additional test cycles, adding time and cost to the project.
What Is UAT (User Acceptance Testing) in SAP?
User Acceptance Testing in SAP is the phase where business users validate that the system supports their actual day-to-day processes. UAT in SAP takes place after SIT has been completed and all critical defects have been resolved, making it the final quality gate before go-live.
UAT in SAP is process-driven rather than technically oriented. Business representatives such as finance managers, warehouse supervisors, or HR coordinators work through end-to-end scenarios that reflect real post-go-live usage. User Acceptance Testing in SAP covers full business processes from start to finish, including:
- Order creation through to invoice posting
- Goods receipt and inventory updates across connected modules
- Payroll runs and their impact on financial reporting
- Customer-specific pricing and discount calculations
The QA team supports UAT in SAP by preparing test scripts, tracking defect resolution, and coordinating between business users and the technical team. The responsibility for executing tests and confirming outcomes, however, sits with the business rather than with the tester.
UAT in SAP typically runs in a dedicated environment that mirrors the production system as closely as possible. Sign-off from business stakeholders at the end of this phase formally authorizes the go-live. Without it, the project remains open regardless of what the technical testing showed.
Key Differences Between UAT and SIT in SAP

Both phases are mandatory in any serious SAP project, but they answer fundamentally different questions. SIT in SAP asks whether the system is technically sound. UAT in SAP asks whether the system works for the people who will use it every day.
|
|
SIT in SAP
|
UAT in SAP
|
|
Primary goal
|
Verify technical integration between modules and systems
|
Confirm the system supports real business processes
|
|
Who executes
|
QA engineers and technical consultants
|
Business users and process owners
|
|
Test basis
|
Functional and technical specifications
|
Business process scenarios and user stories
|
|
Environment
|
Integration test environment
|
UAT environment mirroring production
|
|
Defects found
|
Configuration errors, data mapping issues, integration failures
|
Process gaps, missing requirements, usability issues
|
|
Sign-off owner
|
QA lead or technical project manager
|
Business stakeholders
|
|
Timing
|
After unit testing, before UAT
|
After SIT, before go-live
|
The most practical distinction is ownership. System Integration Testing in SAP is owned by the project and QA team. User Acceptance Testing in SAP is owned by the business.
When to Use SIT and UAT in SAP Projects

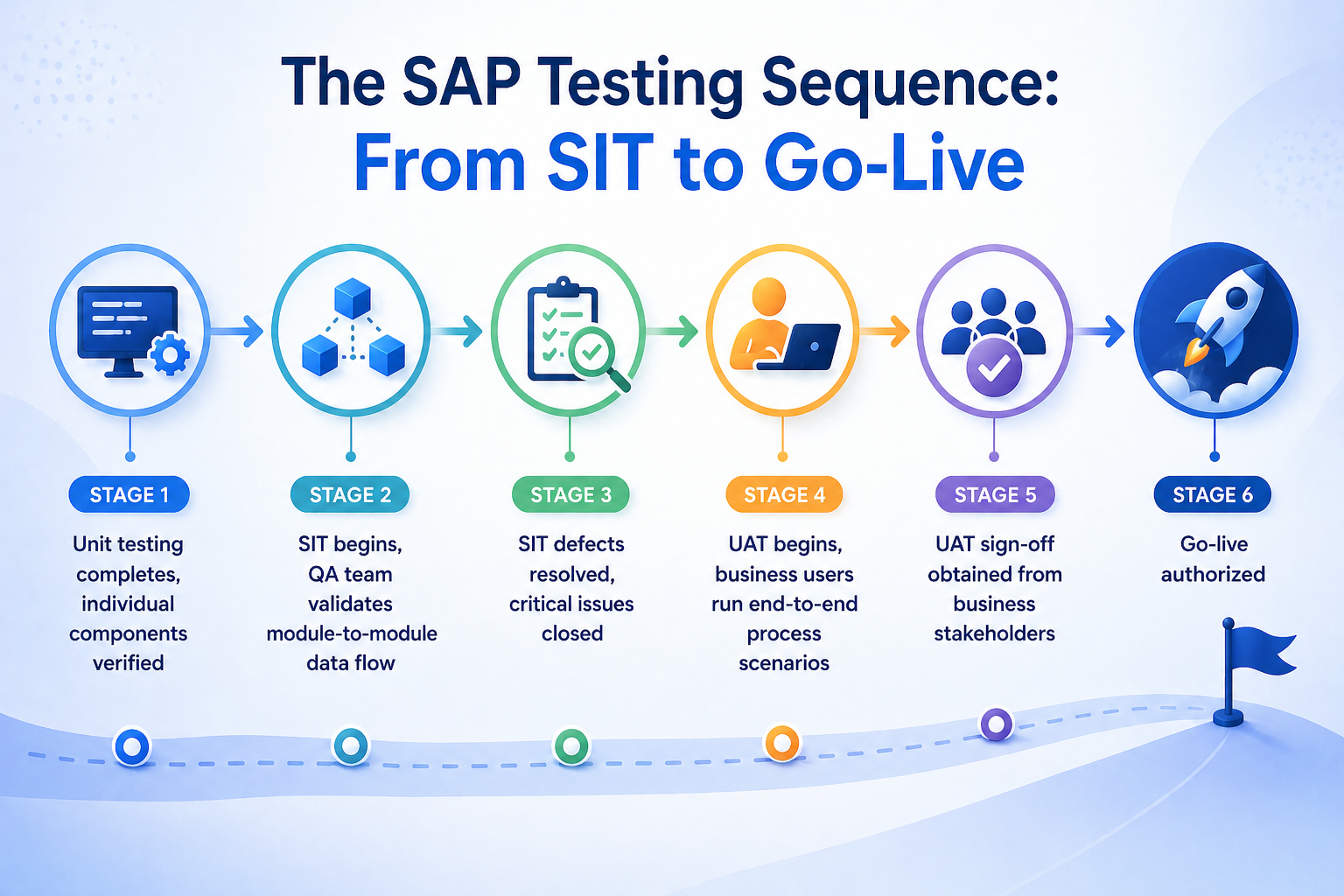

The sequence of these two phases is not interchangeable, and the timing of each has a direct impact on project outcomes. Running them out of order or overlapping them without clear boundaries is one of the most common sources of rework on large SAP programs.
SIT in SAP comes first. Once individual components have been tested in isolation, System Integration Testing in SAP confirms they work together in combination. This is where QA teams catch integration defects that unit testing cannot surface, for example, a pricing condition in SD that calculates correctly on its own but produces wrong results when combined with a customer-specific discount table.
UAT in SAP follows once the system configuration is stable. At this point:
- Data migration should be in progress or complete
- Business teams should have received sufficient training to execute realistic scenarios
- All critical and high-priority SIT defects should be closed
- The UAT environment should reflect the production setup as closely as possible
Some SAP projects, particularly large multi-phase rollouts, run parallel SIT in SAP and UAT in SAP cycles for different workstreams. A tester managing both phases needs clear documentation of which environment, dataset, and scenario set applies to each phase. Mixing the two leads to duplicated defect reports and misclassified failures that slow the entire project down.
Conclusion
SIT in SAP and UAT in SAP serve distinct roles in any implementation project. System Integration Testing in SAP proves the system is technically sound. User Acceptance Testing in SAP proves it works for the people who will use it every day. Running them in the right sequence, with the right QA team and business stakeholders involved at each stage, is what separates a smooth go-live from one that requires emergency fixes in production.
